Programme updates: Warwick and Leamington
Below is a summary of all S278 works as of Winter 2026.
Please note the program of works changes weekly. Please be reminded that as we move through autumn and winter months we may be constrained by various factors, such as inclement weather.
Developers and contractors are committed to delivering on all WCC program dates within given timescales.
Construction of a new Left In Left Out (LILO) junction for The Asps development
Scheme information
Details
Activity
Construction of a new Left In Left Out (LILO) junction for The Asps development
Developer
Taylor Wimpey / Bloor Homes
Contractor
To be confirmed
Status of works
Technical review
Start date planned
April 2026
Completion date
Winter 2026
Scheme information
Details
Activity
A new ghost right turn junction for the development along with the installation of a toucan crossing point over Gallows Hill
Developer
William Davis
Contractor
Henderson Taylor
Status of works
In progress
Start date planned
February 2026
Completion date
Autumn 2026
Scheme information
Details
Activity
Construction of new roundabout, footpaths and cyclepaths with associated street lighting and road markings
Developer
Vistry Homes
Contractor
To be confirmed
Status of works
In progress
Start date planned
Early 2027
Completion date
To be confirmed
Completed schemes
The ASPS – Leamington Spa/Banbury Road Widening
Scheme Overview - Creating drainage works, surfacing roads, upgrading the existing street lighting, installation of traffic signals and the introduction of new splitter islands. Further information can be found on the The ASPS update page.
Completed Winter 2025
Gallows Hill, Warwick
Scheme Overview - Additional work at the new Fusiliers Way junction to install new signage. Further information can be found on the Gallows Hill, Warwick 2025 update page.
Completed April 2025

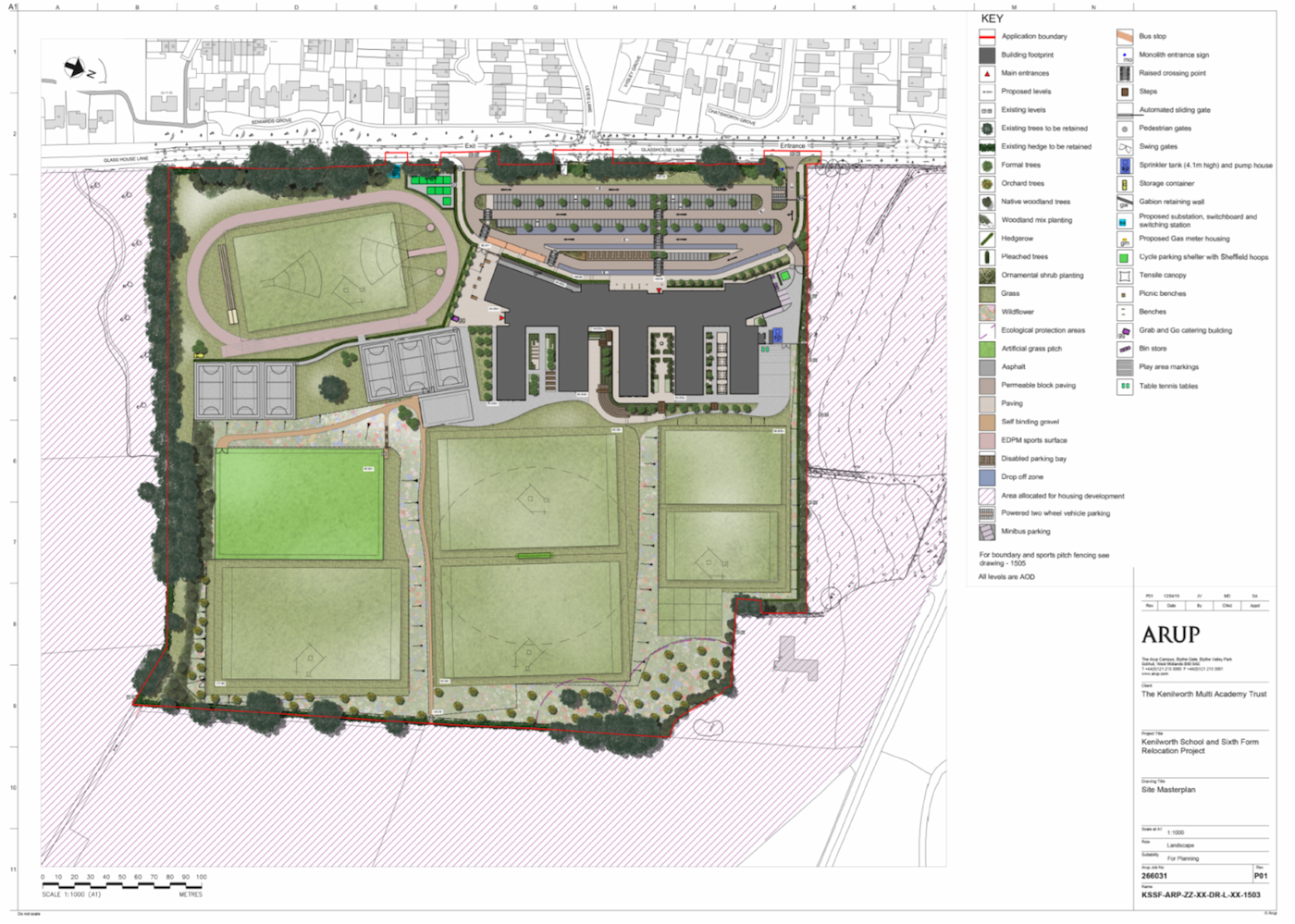

D7069 Glasshouse Lane - Kenilworth School
The school was delivered on behalf of Kenilworth Multi Academy Trust (KMAT) working in partnership with Warwick District Council by Morgan Sindall Construction.
The new three-storey campus, for 2,200 students, opened in September 2023.
Completed Winter 2025/26
